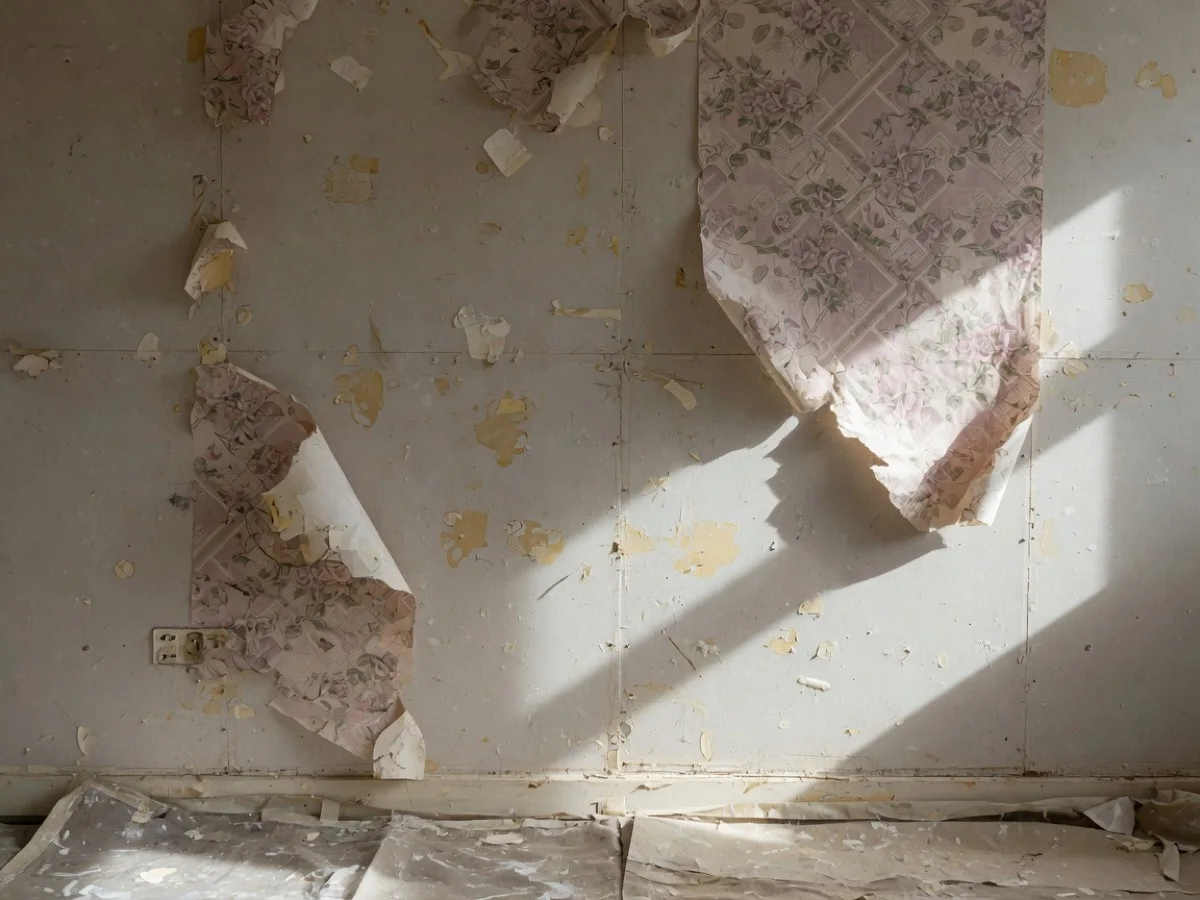

Wallpaper removal is only half the job
Homeowners often budget for stripping and a quick paint. In Auckland renovations, the expensive surprise is the wall underneath: torn paper face, uneven plaster, old lining paper, or joints that only looked flat under patterned wallpaper.
Plan the finish level before the first sheet comes off so you are not negotiating skim coats mid-project.

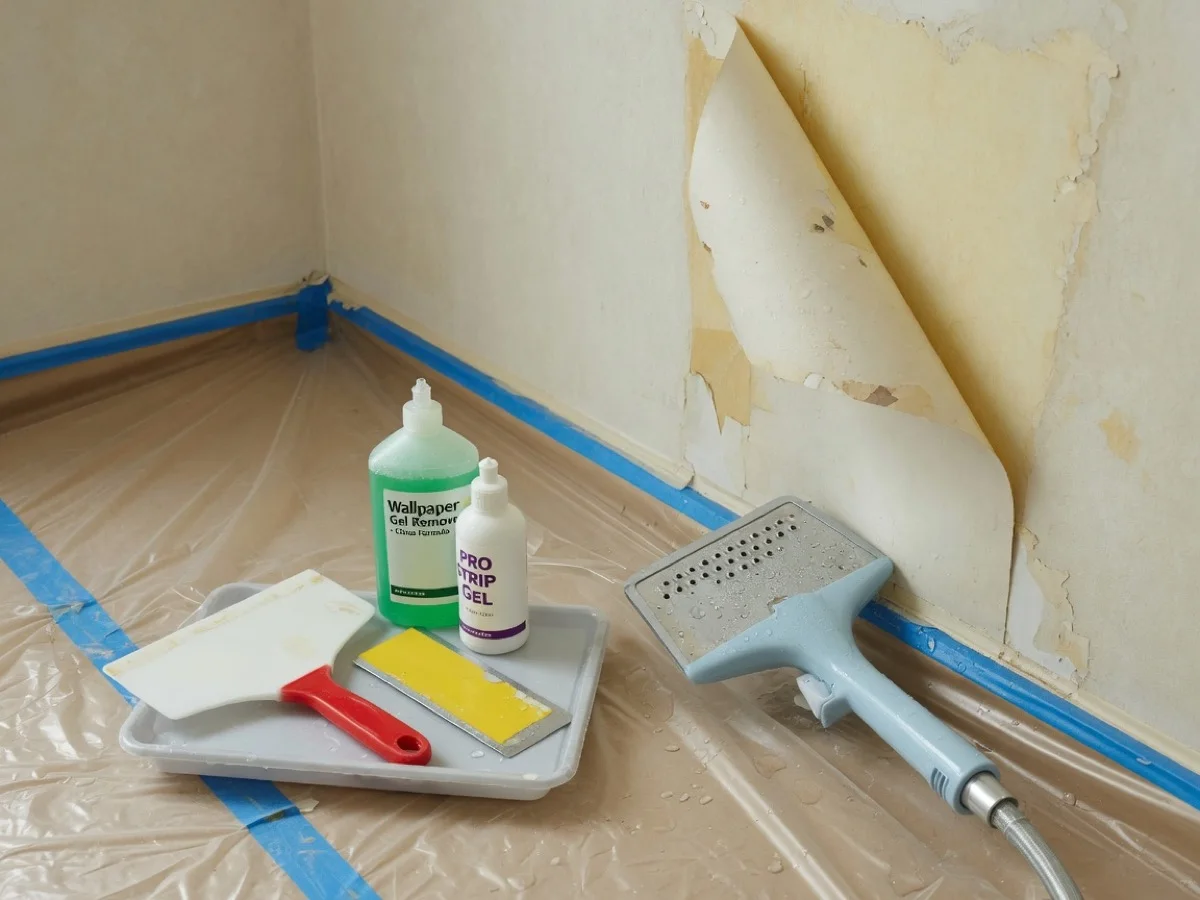

How to strip without destroying the wall
Score carefully where needed, use appropriate removers or steam, and keep water controlled so plasterboard faces do not delaminate. Aggressive scraping creates hollows that scream under low-angle light after painting.
Multiple wallpaper layers, especially in villas, can hide decades of patching. Allow time for discovery.
- Test a small area to learn how many layers and what adhesive you face.
- Protect floors and joinery—strip slurry stains permanently.
- Remove adhesive residue; paint will not stick reliably to glue film.
- Dry the room thoroughly before plaster or primer.
What you might find after wallpaper comes off

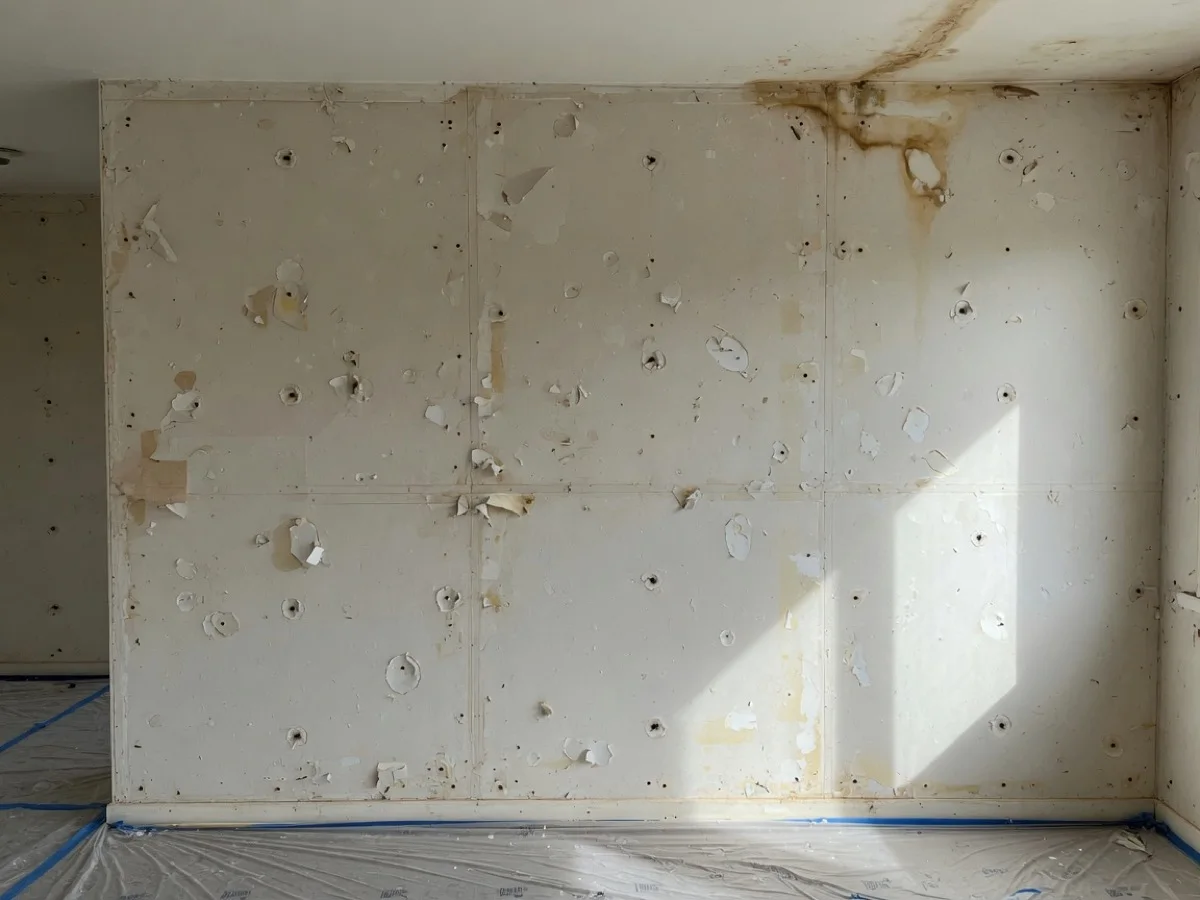

- Paper face of plasterboard damaged in patches.
- Hairline joints and screw pops previously masked by pattern.
- Different wall linings in the same room after past renovations.
- Mould or moisture staining that needs a source check, not only bleach and paint.
If walls are damp or musty, fix moisture before any skim or premium paint system.

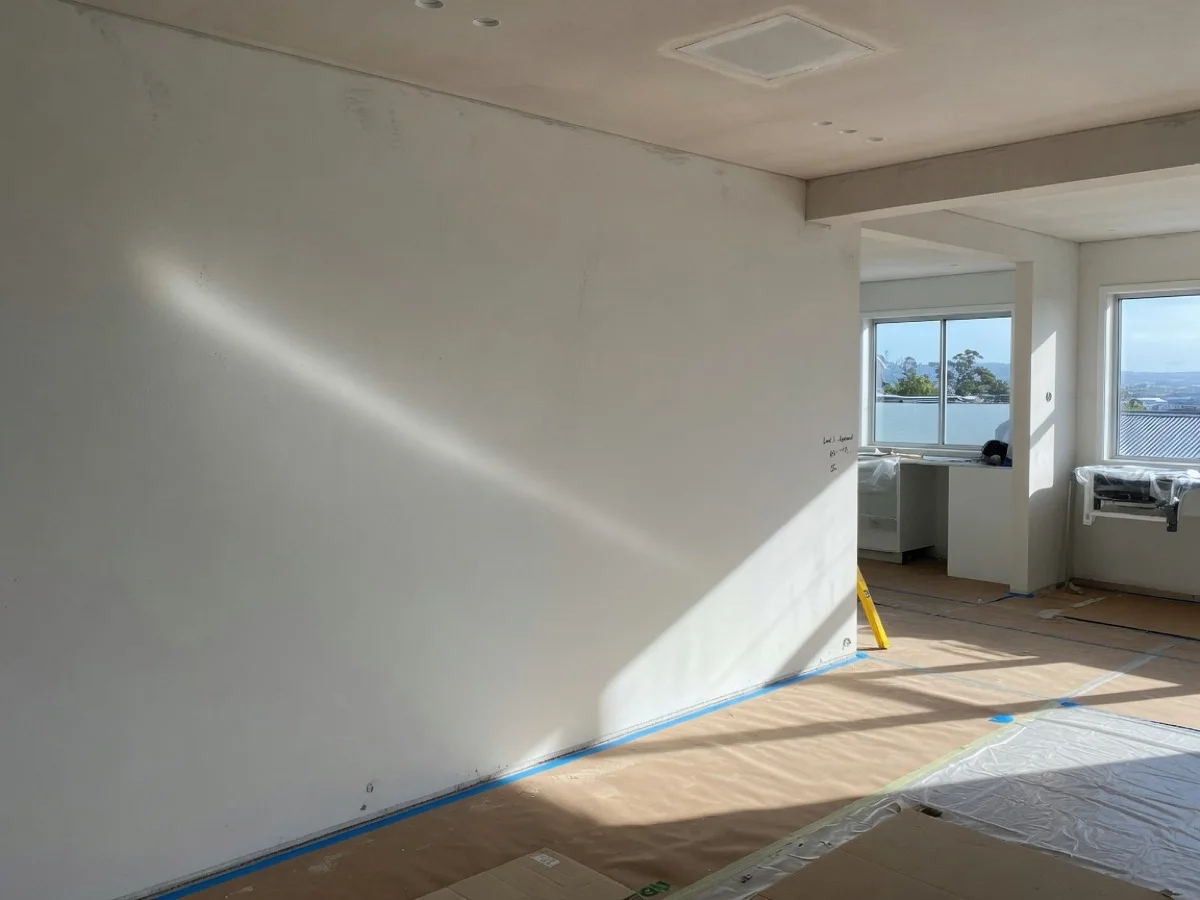

When Level 5 plaster makes sense
Level 5 is a thin skim that equalises the whole surface for critical light. It is not automatically required for every hallway. It is most valuable where large flat walls meet strong side-light, dark colours, or higher sheen paints that highlight imperfections.
Strong candidates for Level 5
- Open-plan living with windows washing light across long walls.
- Dark or deep colours planned after renovation.
- Feature walls viewed head-on in daylight.
- New plasterboard that must look monolithic under downlights.
When a lower finish may be enough
- Low-light utility rooms with flat paint and busy furnishings.
- Budgets that prioritise other structural work—if expectations on “perfect flat” are adjusted in writing.

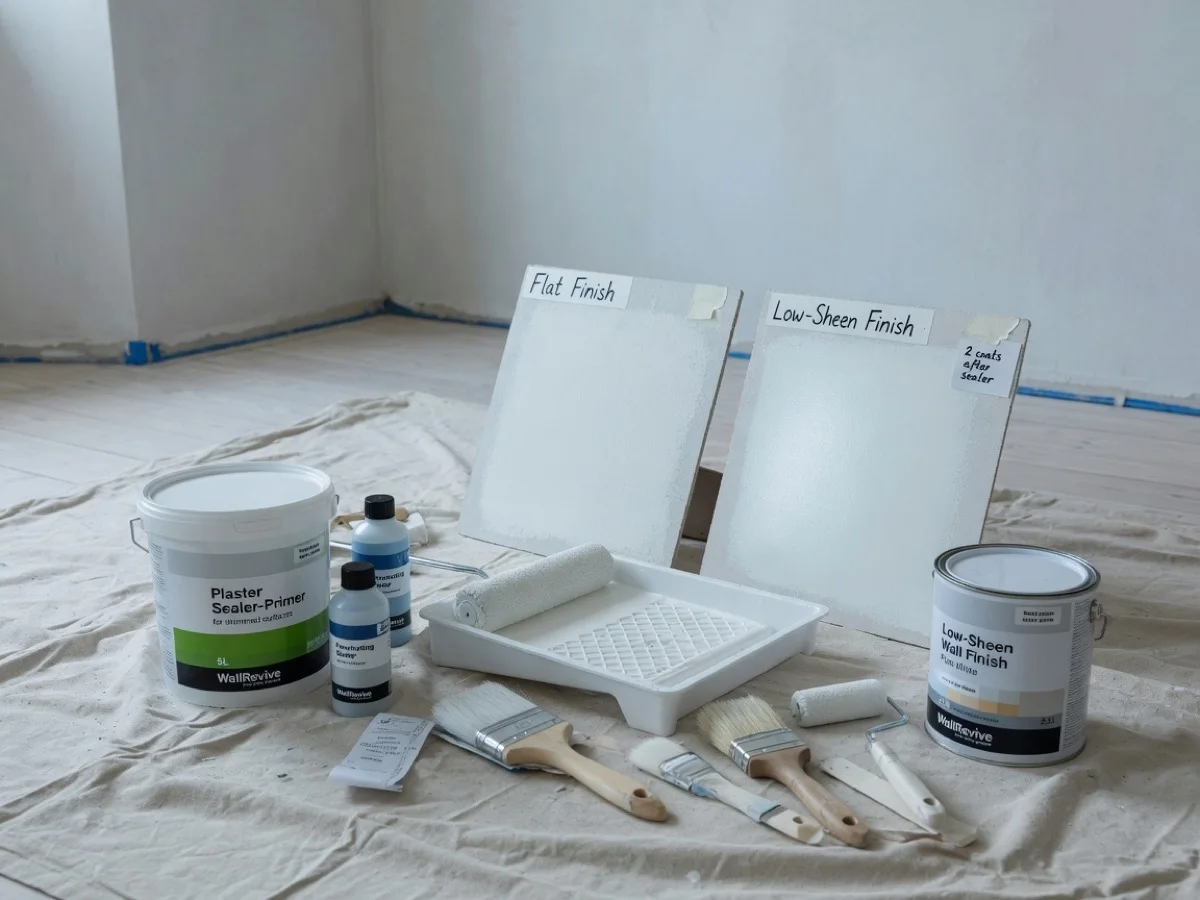

Primers and paint after strip or skim
Use sealers suited to porous plaster and repaired board. Spot-prime patches so they do not flash through finish coats. Choose sheen knowingly: higher sheen shows more; dead flat hides more but can mark in family areas.
- Agree finish level in the quote before stripping day.
- Include adhesive removal, not only paper peel.
- Specify primer and coat count for repaired walls.
- View sample boards in the actual room light if perfection matters.

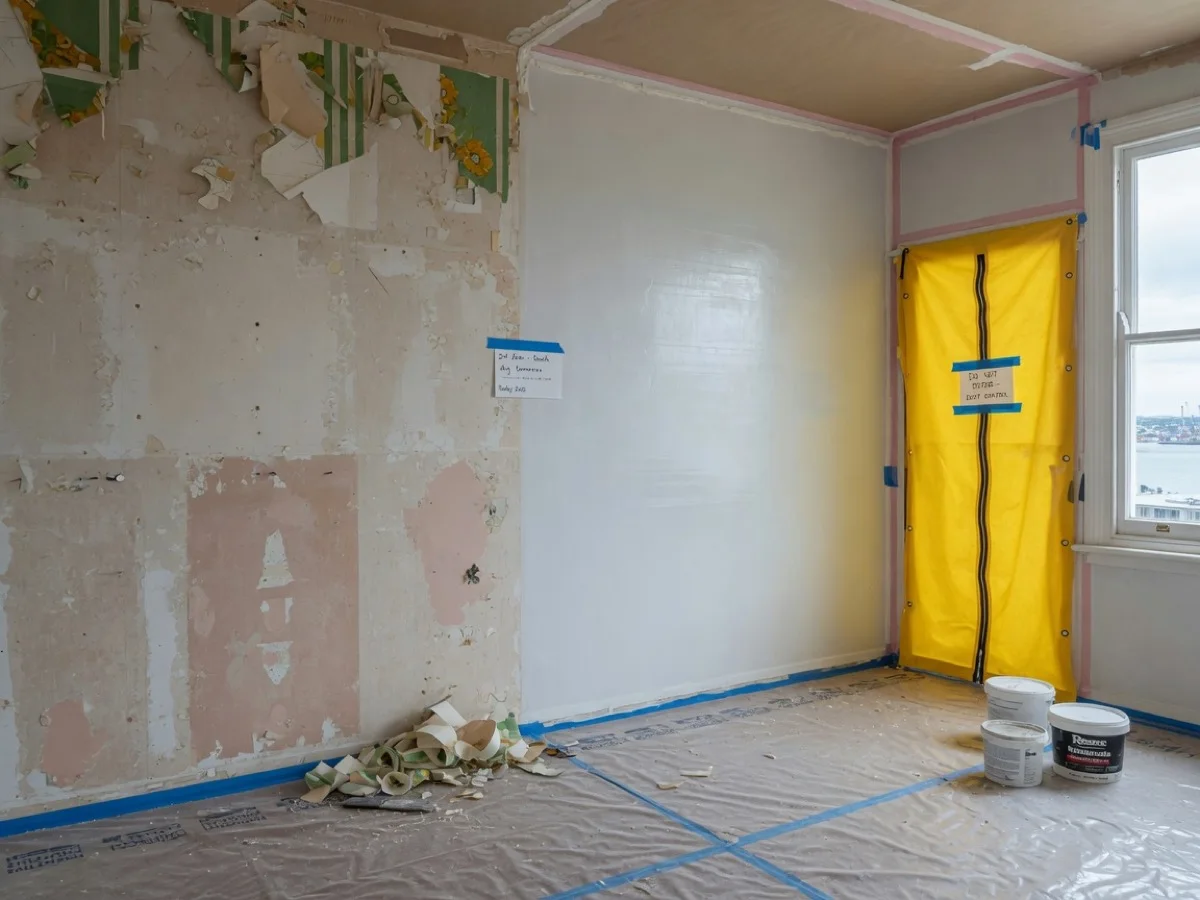

A sensible programme
- Protect floors and empties; isolate dust where possible.
- Strip and clean adhesive; repair board face damage.
- Decide Level 4 touch-ups versus full Level 5 skim.
- Skim, dry, sand dust-controlled; seal.
- Paint system applied after surfaces are truly ready—not when the furniture truck is booked tomorrow.

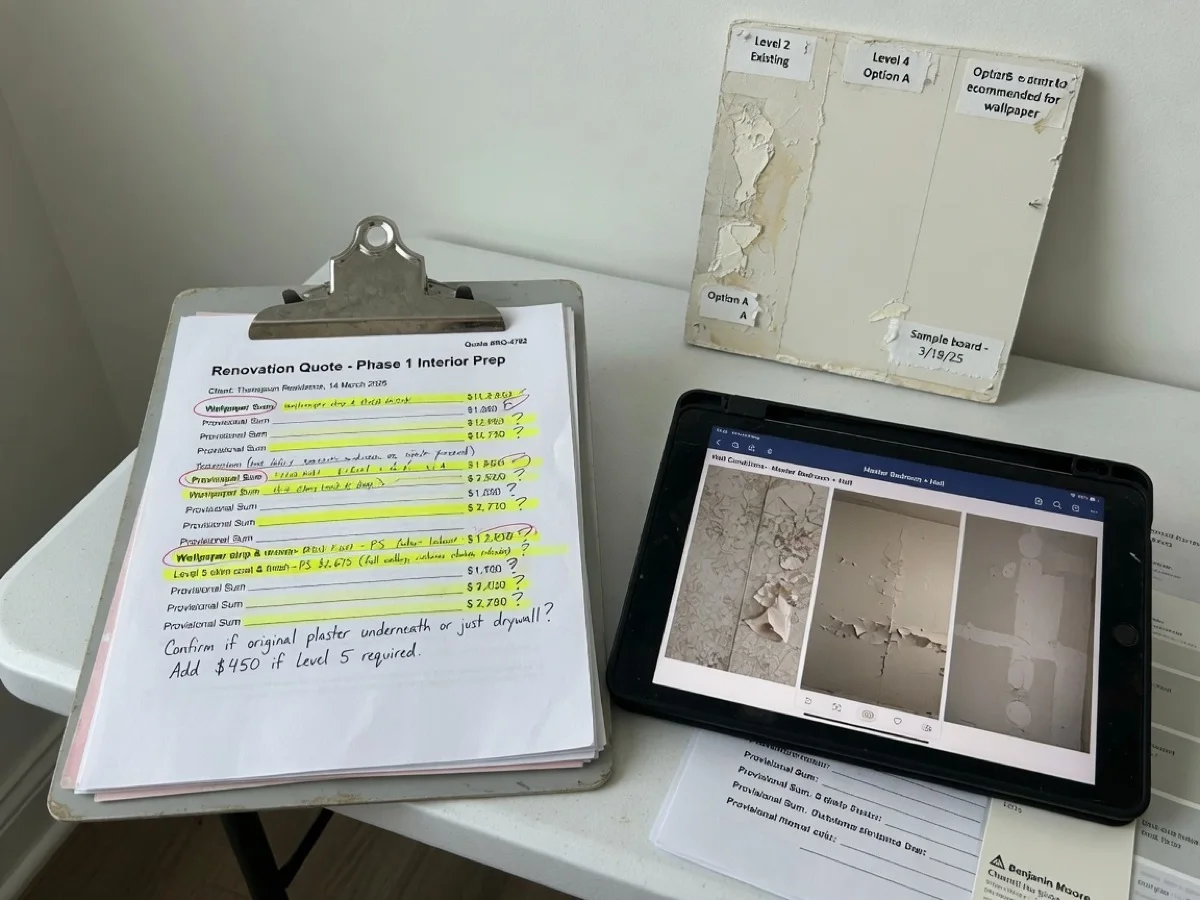

Talking about cost without surprises
Quotes that only say “strip and paint” leave skim as a variation weapon. Ask for provisional sums or a post-strip inspection clause that freezes how Level 5 decisions are priced.
Next steps after wallpaper decisions
If you are renovating rooms with wallpaper or critical light, read the Level 5 deep-dive and interior renovation tips, then book a visit so finish level and paint system are chosen together.

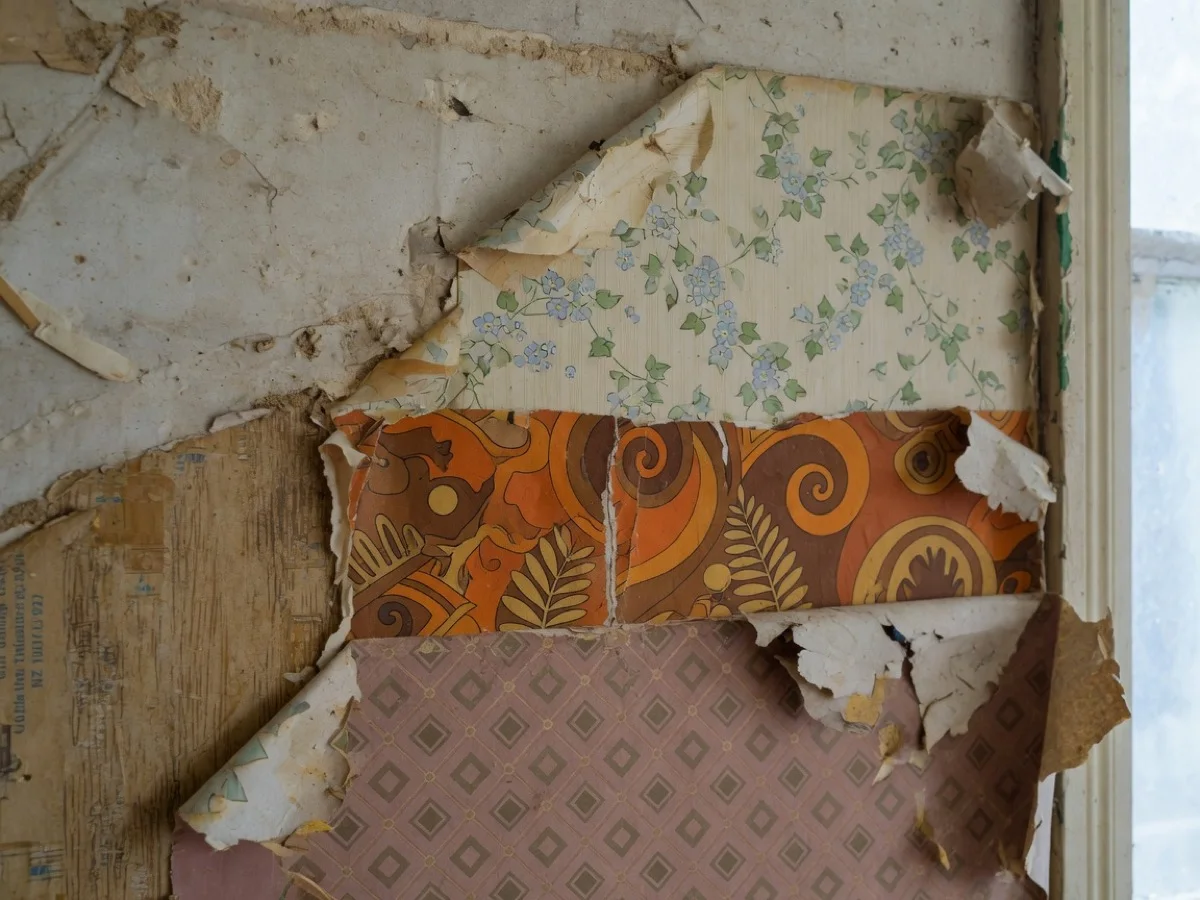

Villa and bungalow layering surprises
Older Auckland interiors may hide lining paper, patchy scrim, or multiple wallpapers. Budgets should allow discovery time after the first wall is opened. Fixed strip prices that assume one modern layer often explode mid-job.
Agree how discoveries are priced: hourly with cap, provisional sum, or pause-and-requote.
Do not book carpet layers the morning after strip day on a villa until walls are assessed.

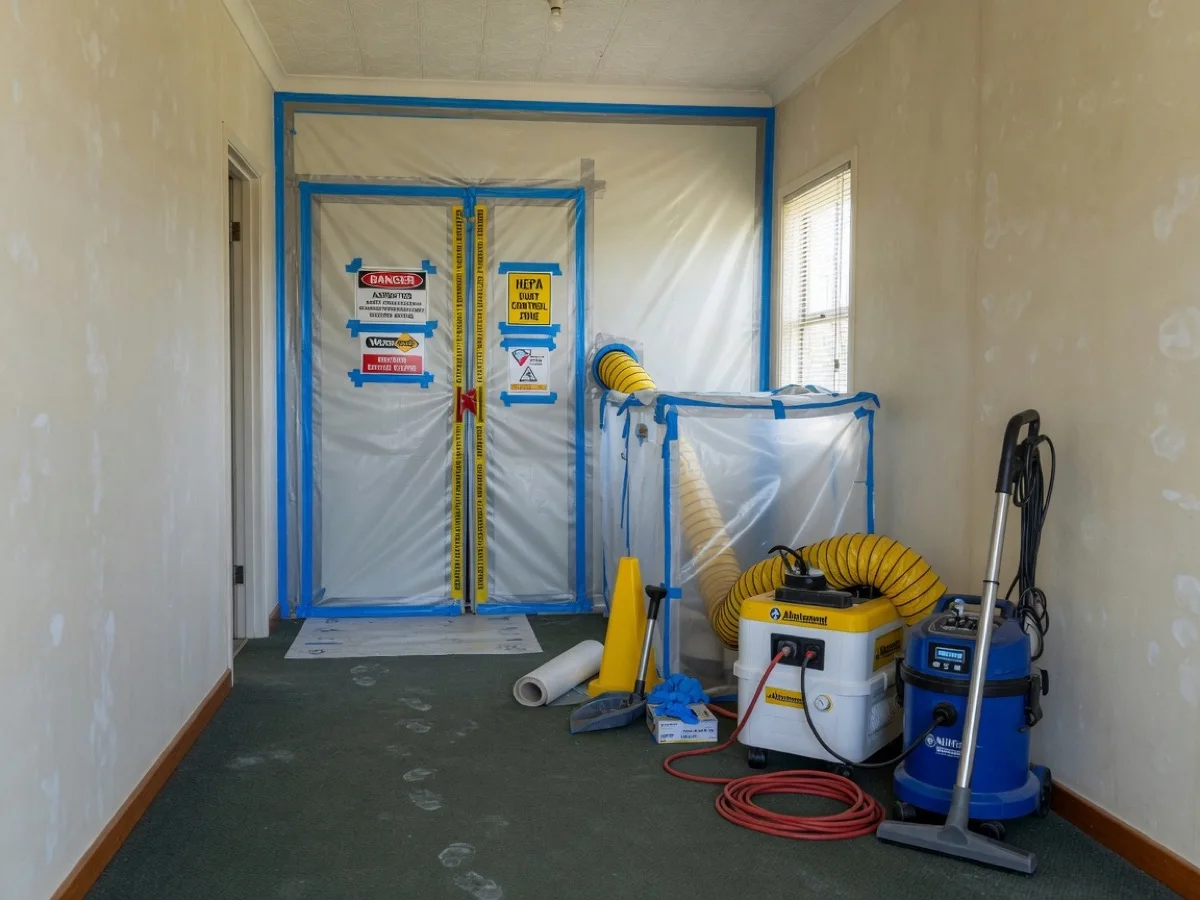

Dust, lead-era paints and occupancy
Sanding after skim creates fine dust. Isolation, air management and cleaning protect occupants. On pre-1980s surfaces, assume risk until tested or treated with appropriate methods—another reason professional strip-and-finish packages matter for family homes.

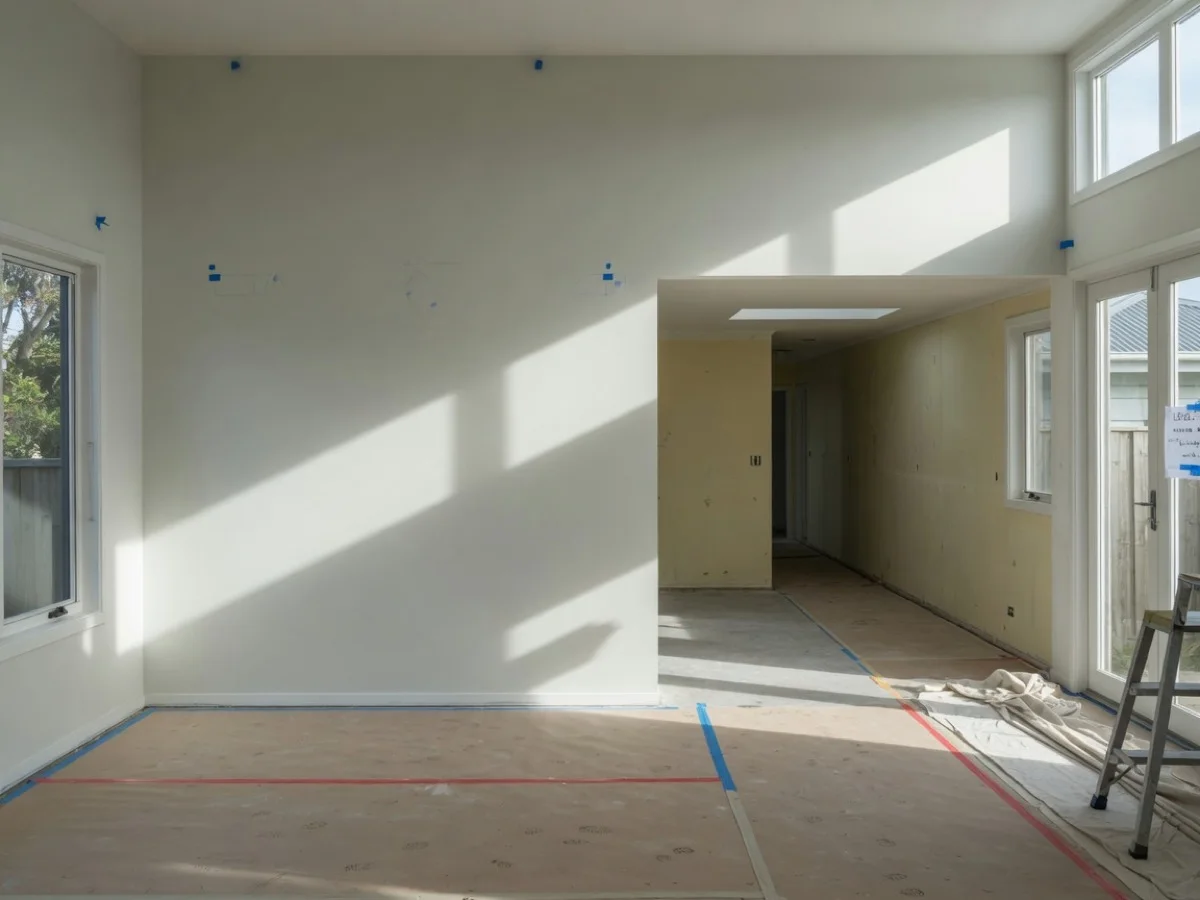

Prioritising rooms when budgets are finite
If you cannot Level 5 the whole house, prioritise the rooms where light and guests meet: living, kitchen dining, main hallway, master bedroom. Leave lower visual demand rooms on a sound lower finish with flat paint and honest expectations.
After wallpaper strip, re-rank rooms based on what the walls actually look like. A bedroom that seemed fine may reveal torn board face; a hallway might be better than feared. Budget flexibility after strip is a feature, not a failure of planning.
Coordinate painters and plasterers so skim dust does not settle on half-finished paint elsewhere in the house. Isolation barriers are mundane and valuable.
- Rank rooms by light criticality.
- Re-rank after strip.
- Isolate dust paths.
- Lock sheen choices to match finish level.

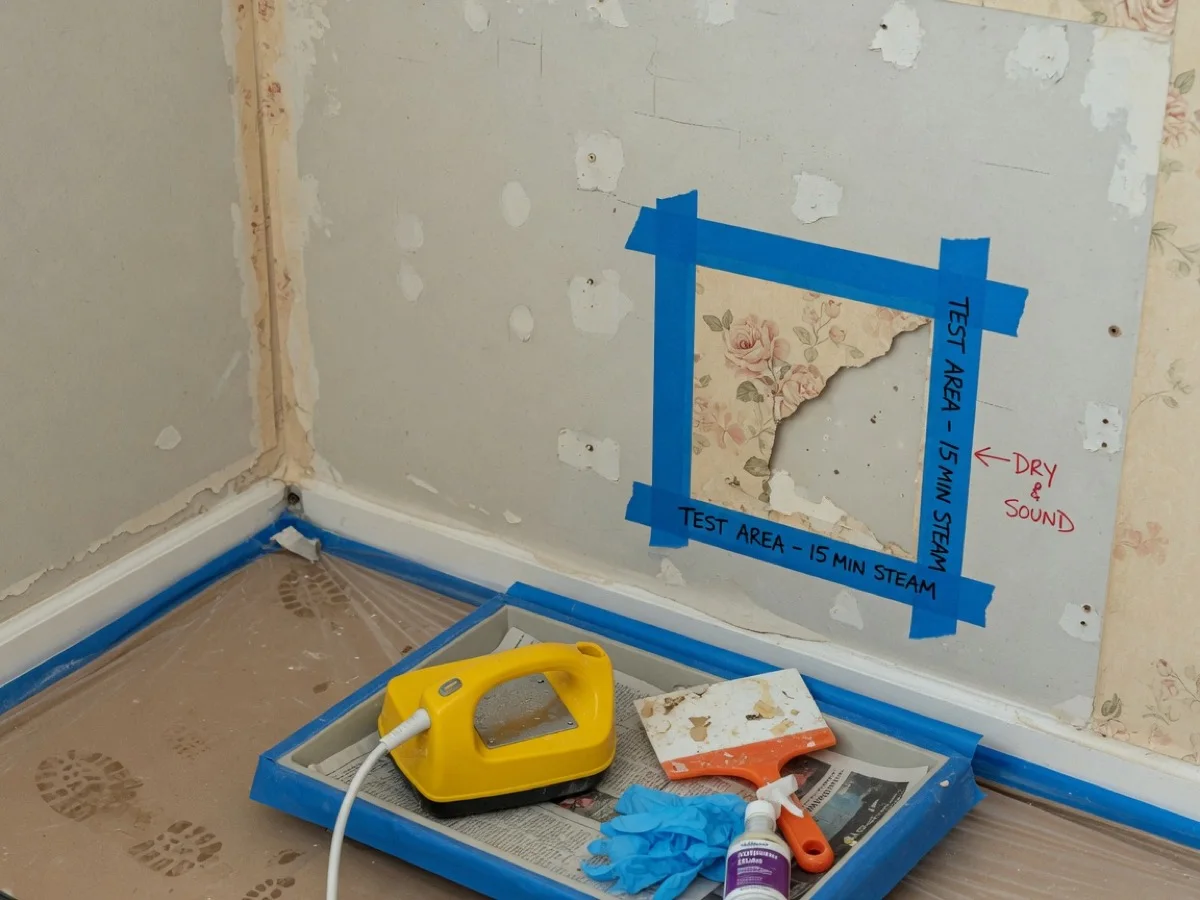

Choosing a strip method that matches the wall history

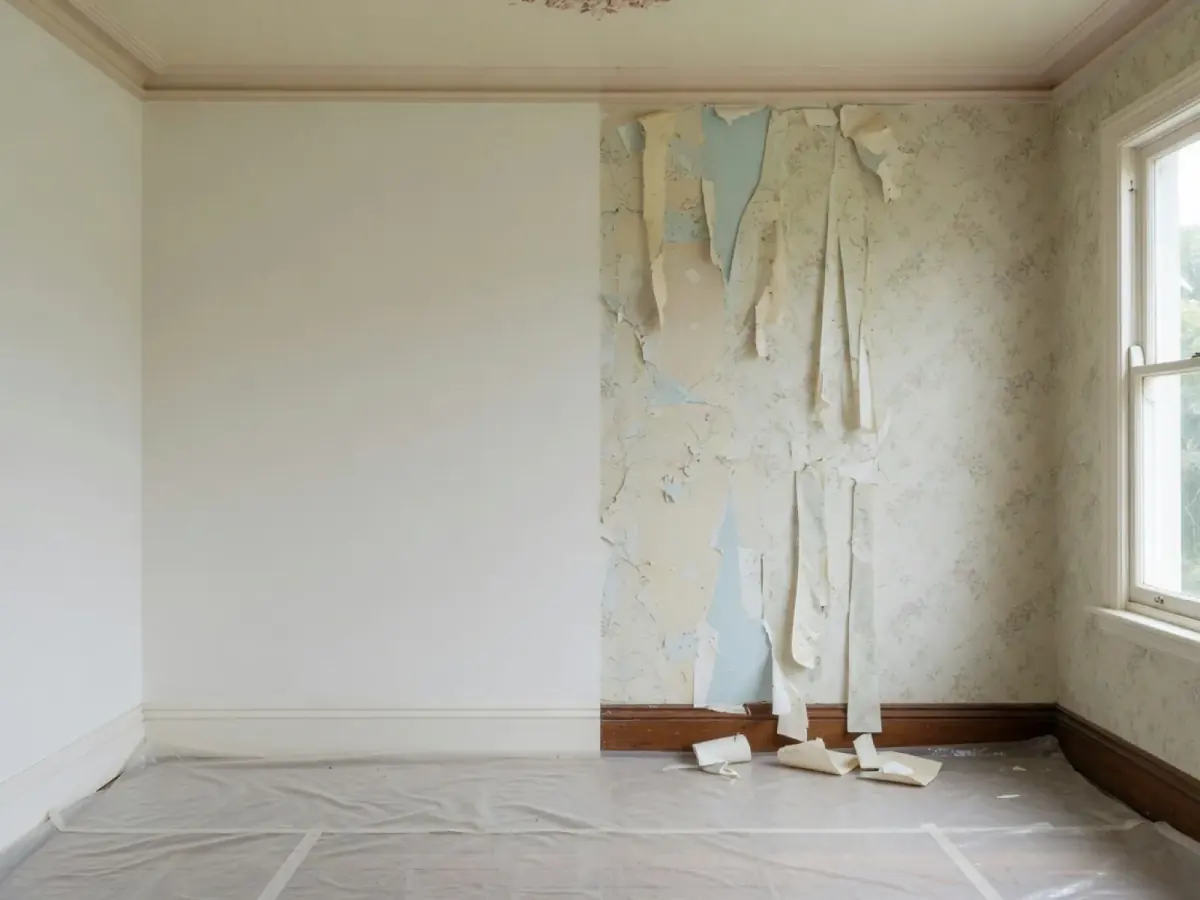

Modern strippable papers behave differently from decades-old layers glued to lining paper over uneven plaster. Test a corner. Steam, gel removers, and careful scoring each have a place; aggressive soaking on weak plasterboard faces can cause more skim work than they save.
If the first wall reveals torn paper face across large areas, pause and re-forecast Level 5 or heavy patching before the whole house is stripped on a fixed low price.
- Test patch before full-room commitment.
- Contain slurry and protect floors.
- Remove adhesive film, not only paper.
- Dry thoroughly before compound.

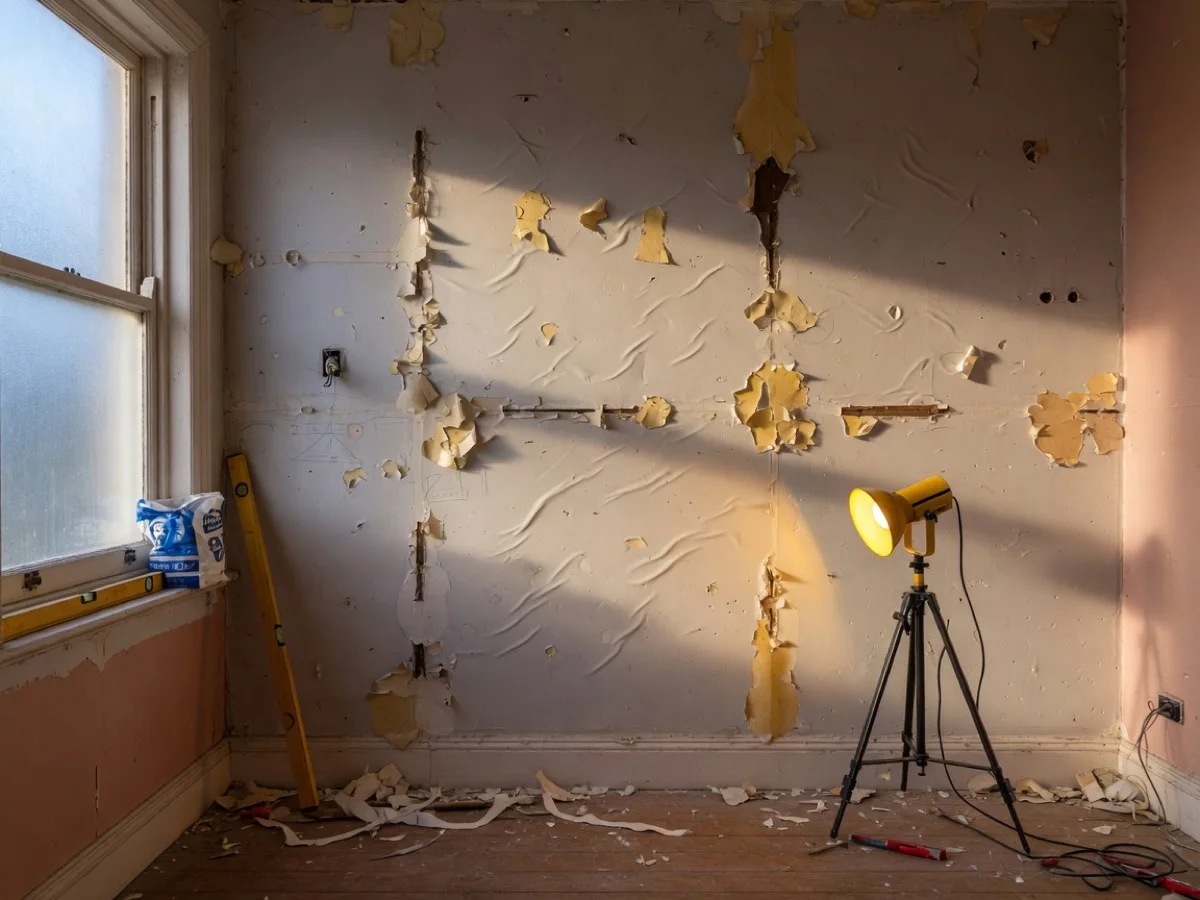

How to use light to decide finish level
Stand in the room at the harshest time of day—often late morning or afternoon side-light. Hold a work light at a raking angle across the wall after strip or after base stopping. Joints and hollows that disappear under wallpaper pattern will announce themselves under paint, especially with dark colours.
That five-minute test is more honest than arguing about Level 5 in the abstract. Mark walls that fail the light test as skim candidates in the quote.
Name rooms: Level 5 / standard stop / undecided pending strip. Do not leave “make it nice” as the scope.

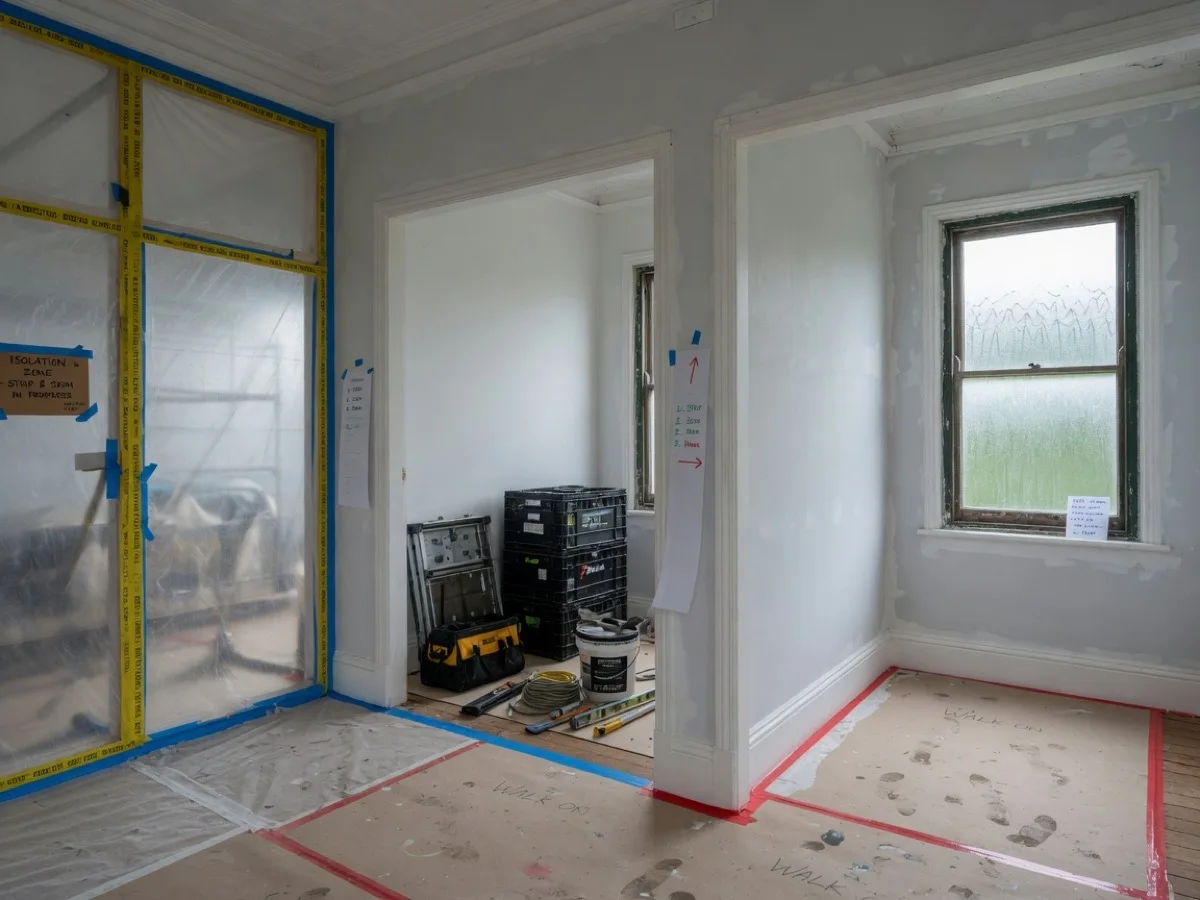

Sequencing strip, skim and paint inside a renovation
Strip creates moisture and mess; skim creates dust; paint needs clean, dry substrate. If builders are still cutting timber nearby, fine dust will settle on fresh compound and primer. Isolate rooms, sequence dusty trades first, and do not book furniture or carpet installers against an optimistic paint day.
For villas with multiple paper layers, discovery time after the first room should be a scheduled hold-point, not an awkward surprise when the plasterer is already booked elsewhere.

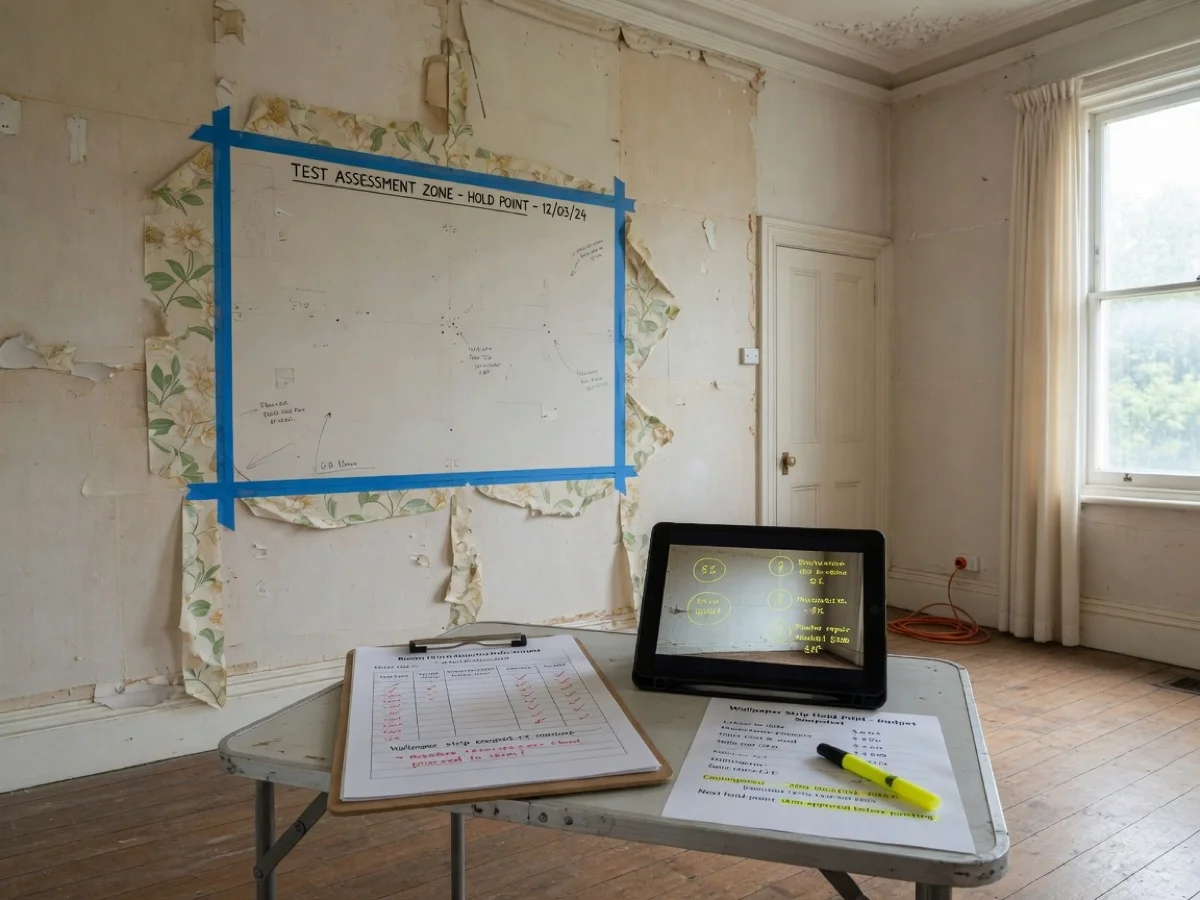

Hold-points and money: avoiding strip surprises
Fixed “strip and paint” prices that assume one modern wallpaper layer fail on villas with multiple papers, lining paper, or damaged board face. Build a hold-point after the first wall: assess damage, confirm Level 5 rooms, and re-forecast before the whole house is opened.
Provisional sums for skim, or a written hourly cap with photo reporting, beat awkward mid-job arguments. Sealers on porous plaster, spot-priming of patches, and sheen choices that match lighting should be in the same conversation as the skim decision.
Dust from sanding Level 5 work needs isolation. If other trades are still cutting timber, fine dust will settle on fresh compound. Sequence matters as much as skill.
- Test strip and assess first wall.
- Lock finish levels by room.
- Skim and dust-controlled sand.
- Seal, prime, paint under agreed lighting expectations.
Need a prep-first site visit?
Tomar Contracting inspects Auckland homes and commercial spaces, then provides a fixed written scope—not a photo guess. Call 0800 TOMAR C (866 272) or use the form below.
